Critical Path Method (CPM)

Technical Name
Critical Path Method (CPM)
Basic Components
Activities (work packages)Duration estimatesDependencies (precedence relationships)Early Start/FinishLate Start/FinishFloatCritical Path
Calculation Steps
List all activities and dependenciesDetermine durationsDraw network diagramPerform forward pass (calculate early dates)Perform backward pass (calculate late dates)Calculate floatsIdentify critical path
Software Support
Microsoft ProjectPrimavera P6AsanaSmartsheet

Critical Path Method (CPM) is defined as a technique used in project management to calculate the minimum duration required to complete a project and to assess flexibility within the project schedule.


According to the PMBOK Guide, CPM is “a method used to estimate the shortest possible project duration and to determine the amount of scheduling flexibility on the logical paths within the schedule model.” In other words, CPM identifies the longest sequence of dependent activities—the critical activities that determine project completion—in a network of tasks with defined precedence and duration estimates. Any delay in any activity on this critical path directly extends the project’s completion date.


For activities outside the critical path in the schedule, a specific period of flexibility (float) exists; even if these activities are delayed, they do not affect the project’s end date. CPM analysis calculates for each activity the early start, early finish, late start, and late finish dates to determine these flexibility periods. Total float indicates how much an activity can be delayed from its early start date without delaying the project’s completion, while free float represents the portion of this delay that can occur without delaying the early start of any immediately following activity. CPM is typically applied using activity-on-node (AON) diagrams, where each activity is represented by a node and dependencies between activities are shown by arrows. The resulting project network diagram visualizes the logical flow of activities and identifies the critical path.

History

The Critical Path Method was developed in the late 1950s. It was first created by Morgan R. Walker and E. W. (James E.) Kelley Jr. at DuPont for planning maintenance projects, and simultaneously by Kelley and Winter H. Orr at Remington Rand Univac for the Polaris missile program. The method aims to determine the minimum project duration by identifying the longest sequence of dependent activities. In the 1960s, the construction industry adopted CPM; for example, one of its earliest applications was during the construction of the Humber Bridge in England. With the advancement of computer technology in the 1970s, CPM transitioned to software applications; one of the first major programs was Primavera Systems, which has been widely used in the construction sector since the 1980s. Today, CPM is enhanced by modern techniques such as integration with BIM (Building Information Modeling) and cloud-based tools, further strengthening project planning. PMI’s PMBOK Standards also recognize and define CPM as a fundamental tool for project schedule analysis.

Core Components

The core components of CPM are as follows:


  • Activity (Task): The smallest units of work required to complete the project. Each activity is assigned a duration estimate.
  • Precedence/Dependency: Relationships are defined such that one activity must be completed before another can begin (e.g., Finish-to-Start relationship). These relationships are represented by arrows in the network diagram.

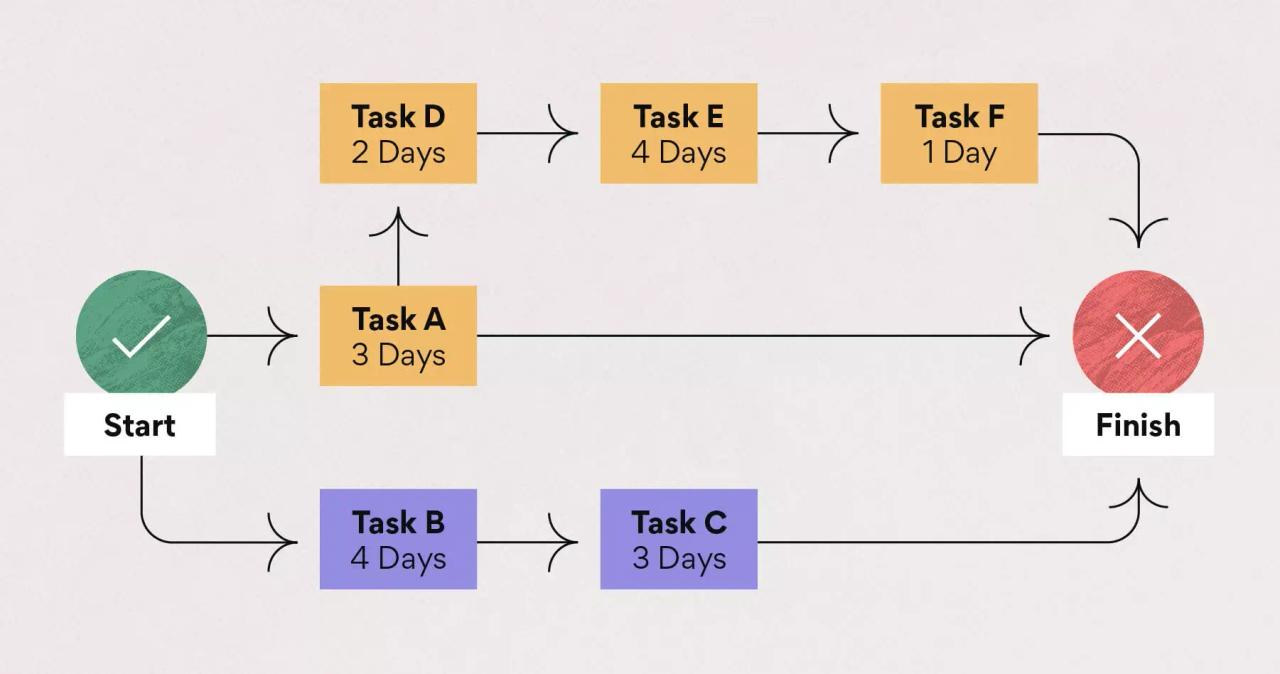

  • Network Diagram: A schematic representation where activities are shown as nodes and dependencies between them as arrows. This visualizes the logical sequence of tasks.
  • Early Start and Early Finish Dates: The earliest possible dates on which an activity can start and finish, given its dependencies.
  • Late Start and Late Finish Dates: The latest possible dates on which an activity can start and finish without delaying the project.
  • Total Float: The amount of time an activity can be delayed without delaying the project’s completion date; total float for critical activities is zero.
  • Free Float: The amount of time an activity can be delayed without delaying the early start of any immediately following activity.
  • Critical Activity and Critical Path: Activities with zero total float are critical activities. These form a continuous sequence with the longest total duration. According to PMBOK, the critical path is “the sequence of activities with the longest total duration in the project, thereby determining the shortest possible project duration.” Any delay on the critical path directly extends the project’s completion time.


CPM calculations typically use a forward-backward pass method: starting from the beginning of the network diagram, early finish dates are calculated; then, moving backward, late start dates are determined. This process clarifies all dates and float values.

Implementation Process

Applying the critical path method requires a step-by-step and meticulous approach. The general process includes the following stages:


  • Activity Definition: All tasks required to successfully complete the project are identified. These tasks are listed in the Work Breakdown Structure (WBS).
  • Dependency Identification: The sequence in which each task must be performed is defined. Some tasks cannot begin until others are completed; dependencies (precedence) and any concurrent relationships are determined.
  • Duration Estimation: The time required to complete each task is estimated. These estimates may include contingency buffers to account for potential delays or uncertainties.
  • Network Diagram Development: A network diagram is created using the defined tasks and dependencies. Each task is represented by a node; arrows between nodes indicate sequence and relationships.
  • Critical Path Identification: The longest path from the project’s start to its end in the network diagram is identified as the critical path. This path represents the minimum duration required to complete the project.
  • Float Calculation: Total float is calculated for each activity. Activities on the critical path have zero float; non-critical activities have a specific amount of allowable delay.
  • Monitoring and Control: The critical path is continuously monitored throughout the project. Any disruption to activities on the critical path directly affects the project’s completion date. As the planning phase progresses, the network diagram and critical path are regularly updated to detect deviations early.


These steps enable the successful creation of a CPM schedule and establish a solid foundation for project planning. Throughout the process, CPM analysis can be used to realistically optimize the project calendar and support proactive risk management.

Software Support and Integration

The critical path method can be easily implemented using modern project management software. Tools such as Microsoft Project and Oracle Primavera automatically perform CPM calculations; project managers can immediately view early and late dates and float values after entering tasks, durations, and dependencies. For example, Primavera Systems, developed in the 1980s, is one of the first computer-based CPM planning software programs and remains widely used today. Currently, CPM is also integrated into 4D BIM and cloud-based projects; 4D BIM refers to linking a building model with its schedule for analysis. Software support offers advantages such as easy creation of complex diagrams, multiple scenario simulations, and real-time updates. However, automated calculations must not be used without a thorough understanding of fundamental CPM concepts, as software tools require a solid grasp of critical path analysis principles.

Advantages

The Critical Path Method provides numerous advantages in project planning:


Project Duration Control: CPM identifies the longest sequence of activities (the critical path), revealing the shortest possible project completion time. This clarifies which tasks directly impact the schedule and allows them to be prioritized for timely completion.


  • Resource Optimization: Identifying critical path activities facilitates the strategic allocation of project resources (labor, equipment, materials, etc.). Prioritizing critical tasks and assigning resources accordingly supports on-time project completion.
  • Risk Management: CPM helps identify potential bottlenecks and delay risks in advance. Monitoring activities on the critical path enables proactive measures to mitigate delays, reducing the potential impact of disruptions on the project.
  • Planning and Communication: Network diagrams and critical path charts visually clarify the project schedule. This fosters a shared understanding among team members and stakeholders regarding task priorities and sequence. CPM enables clear communication of the project plan, timeline, and performance goals to all stakeholders.
  • Performance Tracking: The determination of early and late dates allows comparison between planned and actual progress. Throughout the project, resource utilization and duration estimates are monitored, generating valuable feedback for future projects.


These advantages position CPM as the leading method for complex projects with numerous interdependent tasks. PMBOK also identifies CPM as one of the key tools for effective schedule management during the planning process.

Limits and Considerations

Like any method, CPM has limitations. Key constraints include:


  • Ignoring Resource Constraints: Traditional CPM assumes unlimited resources. Calculations arrange tasks based solely on their sequence and finish dates, without considering resource limitations (e.g., a limited number of workers available simultaneously). As a result, practical conflicts may be overlooked. If resource leveling is required, additional analysis is necessary.
  • Uncertainty and Estimation Errors: CPM uses a single deterministic duration estimate for each activity. Unrealistic duration estimates can mislead critical path and project duration calculations. In practice, for projects with high uncertainty, the PERT approach using three-point estimates is often preferred; however, CPM requires fixed durations.
  • Bureaucracy and Complexity: In large projects with many activities, network diagrams become complex. Preparing such analyses can be time-consuming. Additionally, if the plan changes midway through the project, the network diagram may need to be redrawn—a difficult and labor-intensive task. Continuous updating of the critical path demands attention and discipline.
  • Resistance to Change: CPM follows predefined steps. However, unexpected events on site (e.g., a new approval process or supply delay) may require the entire diagram to be reconstructed. Critical path analysis has limited flexibility in responding to such dynamic changes.
  • Low Team Involvement: The CPM schedule is often prepared solely by the project manager. If the entire team is not actively involved in the process, the task list may be incomplete or inaccurate, leading to an incorrect identification of the critical path.
